Progress of the works - 2 26/11/2026
As part of the next phase of construction of the substation serving the photovoltaic power plant near Dobrich, construction company Varaks continues to carry out key building and civil engineering works on the substation building and its associated infrastructure.
Preparatory works have been completed for the polished concrete floor. The substation's steel structure has been installed, followed by the completion of the polished concrete flooring.
A retaining wall is currently being constructed on the northern side of the substation to stabilise the surrounding ground.
Work has also commenced on the construction of cable trenches, cable manholes and cable ducts. These are specialised civil engineering structures that require precise execution of excavation, formwork, reinforcement and concreting works, as well as accurate positioning of cable routes and openings to accommodate cable installation.
At the same time, work on the perimeter fencing is progressing. The foundations have been completed, followed by the construction of a solid concrete boundary wall.
A major milestone in the project is the delivery and installation of the main power transformer. This is one of the largest and most important items of electrical equipment on site, playing a key role in converting and transmitting the electricity generated by the photovoltaic plant to the power grid. Due to its considerable size and weight, transporting, lifting and positioning the transformer onto the pre-constructed reinforced concrete foundation requires specialised heavy-lifting equipment and careful coordination of the installation works.
Installation of a lightning protection mast is also underway as part of the facility's lightning protection system.
Progress of the works 24/11/2026

Building company Varaks-Stroy is continuing the works on the foundations for transformer stations and battery storage units in Targovishte. At this stage of construction, the installation of prefabricated reinforcement structures for the columns has begun. A significant portion of the work involved the fabrication, transportation and positioning of these elements. In a dedicated work area, our team prepared the necessary column reinforcement, which was subsequently installed in the designated locations within the foundations. In the meantime, the construction crew gained some new four-legged friends, who have brought a cheerful atmosphere to the site.

Construction activities proceeded with the pouring of the foundations, using concrete specified for structural elements exposed to specific moisture conditions. A two-layer waterproofing system using Ceresit CR 90 was applied, providing additional protection for the structures. Work has also begun on the formwork for the reinforced concrete columns. At the same time, the construction of the remaining foundation structures is underway, with activities organized in phases across different sections of the site.

This was followed by the concreting of the columns, which are characterized by precise execution and excellent geometry.

At this stage of construction, a large-scale foundation infrastructure is taking shape on the site, comprising numerous reinforced concrete bases and vertical structural elements essential for the future installation of the transformer stations and the energy storage system.

Progress of the works 19/11/2026

Construction works on the ramps for a photovoltaic power plant near Dobrich are ongoing. The team of construction company "Varaks-Stroy" has completed the formwork and installed the reinforcement for the reinforced concrete beams on both sides of the ramps. The reinforcement cages, which serve as the load-bearing foundation for the reinforced concrete ramps, have been made.

Construction activities continued with backfilling and the laying of a polyethylene membrane. Subsequently, the reinforcement framework was installed.

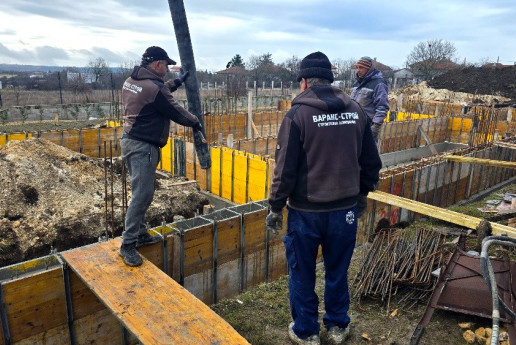

The construction process proceeded with the pouring of concrete for the reinforced concrete ramps. The concrete mix was delivered by mixer trucks and placed using a concrete pump, as construction workers then spread, vibrated and leveled the concrete to achieve the required surface flatness.

November 2026 16/11/2026
Construction work on the luxury single-family home in the Varna area has reached the finishing stage. The project is now entering its final phase, with the team from the construction company "Varaks-stroy" actively working on interior design elements, utility installations and the completion of the facade.
Inside the building, fine plastering and painting are being carried out on the walls and ceilings. Modern lighting fixtures - including decorative pendant lights and recessed LED lighting - have been installed, contributing to a contemporary interior aesthetic.
Concurrently, the technical room is being equipped; water heaters and a heat pump system have already been installed. In the bathrooms, finishing work continues with the laying of tiles and the installation of sanitary fixtures. High-quality construction materials from MAPEI are being used for the application of wall and floor coverings.
The exterior of the house is nearing completion. The white facade render, anthracite-colored window frames, and the metal structure of the veranda define the building's modern architectural look. Work is ongoing on the covered veranda, alongside preparations for the final completion of the outdoor spaces. With each successive stage, the construction company "Varaks" brings the project closer to a complete "turnkey" finish, prioritizing high-quality materials, professional execution, and meticulous attention to every detail.
End of the works 04/11/2026
Construction company Varaks has successfully completed the construction works for the foundations of lightning protection masts at a photovoltaic power plant near Dobrich.

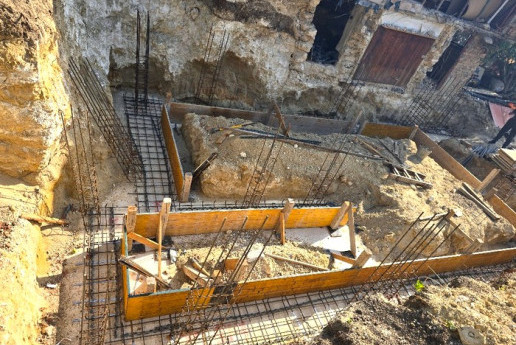

The construction of the foundations involved the installation and subsequent removal of the formwork for their above-ground sections. The construction team carried out the precise concreting of the foundations using a concrete mixer pump.
As part of the works, an earthing component was integrated into the reinforcement of the foundations and the main section of each lightning protection mast was installed. The necessary installation activities, including the positioning and manual erection of the structures, were also completed.
With the completion of the construction and installation works, the required stability and structural support for the lightning protection system's equipment at the photovoltaic park were ensured.
This project is yet another example of the professionalism, technical expertise and responsible approach demonstrated by the Varaks team in delivering specialised construction works for energy infrastructure projects.
October 2026 30/10/2026

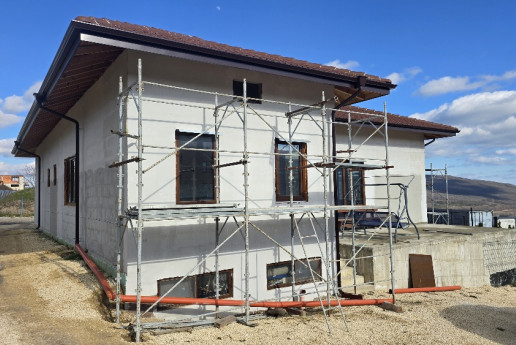

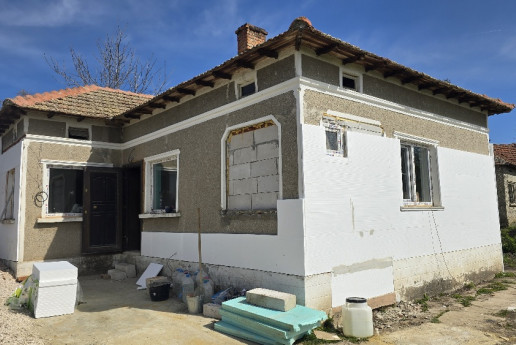

Construction company Varaks is continuing the construction of a single-family house in Balchik area. At this stage, we are installing EPS thermal insulation, commonly known as Styrofoam, on the facade. We are systematically covering the building's exterior walls, paying special attention to high-quality workmanship and detailing. The goal is to ensure reliable thermal protection, improved energy efficiency and comfort throughout all seasons.
Progress of the works - 3 29/10/2026
Varaks construction company is continuing construction and renovation work on the residential building in Kavarna. Following the completion of major demolition activities and the construction of new masonry, the project has moved to the next phase: the installation of the building's electrical system.
Electricians are routing new cabling, having first prepared channels within the walls and ceilings. Electrical cables are being laid and distributed to the various rooms. Provisions are being made for the installation of switches, sockets, junction boxes and light fixtures with their placement aligned to the new functional layout of the living spaces.
The team is focused on ensuring an organized installation and the precise positioning of electrical points. This well-planned layout allows for independent power supply to individual household appliances, ensuring maximum convenience for daily use.
End of the works 29/10/2026

Construction company "Varaks-Stroy" has successfully completed the construction of foundations for a video surveillance system at a photovoltaic power plant near Dobrich.

As part of the project, our team of construction workers carried out all necessary tasks, including site preparation and excavation, reinforcement, formwork, concreting, the installation of conduits for technical cabling, as well as the precise positioning and leveling of the cast foundations.

This project is part of our operations in the field of industrial and infrastructure construction - specifically the development of photovoltaic parks and the associated infrastructure for energy facilities. With the completion of this project near Dobrich, we once again demonstrate our professionalism and expertise in executing construction works for photovoltaic power plants, as well as in building foundation structures and infrastructure for security and video surveillance systems.

Progress of the works - 4 27/10/2026

Construction company Varaks continues work on a single-family house in Varna, with the project progressing towards the next stages of the interior finishing works.

The house façade has been fully completed and the scaffolding has been dismantled. The internal machine-applied plastering of the walls and ceilings has also been completed, preparing the rooms for the following construction and finishing works.

The construction team is currently laying cement screeds throughout all the interior rooms of the house, as well as on the terrace. All screeds are being carefully levelled to provide a smooth, stable and even base for the installation of the final floor coverings.

Progress of the works 05/10/2026

The building works are ongoing on the water storage tanks for fire protection needs for the photovoltaic power plant near Dobrich. Construction company Varaks did the ground preparation, including the placement of gravel, levelling and compaction. A polyethylene membrane was then laid, followed by the construction of a reinforced concrete foundation slab with double-layer reinforcement mesh to ensure the required structural stability.

Upon completion of the preparatory and concreting works, the prefabricated tanks, each with a capacity of 32 m³, were installed. The installation was carried out with the necessary precision, in accordance with the pre-marked tank locations.

HDPE (high-density polyethylene) pipe connections were installed, including pipes, fittings, flanges and welded joints.

The tank ventilation system was also installed, including the required air vents.

The staged filling of the tanks with water using water tanker trucks has commenced as part of the commissioning process.

Subsequently, preparations were made for the construction of a concrete containment basin around the tanks, including the installation of the required formwork. Once the preparatory works were completed, the basin was concreted, followed by backfilling around the tanks with sand.
