The construction of this house in Balchik, Rogachevo village includes:
- Excavation and construction of foundations;
- Formwork and reinforcement works;
- Laying concrete;
- Masonry;
- Plaster/render and screedings;
- Flooring;
- Construction of a roof;
- Painting and decoration.
Building a house in Balchik, Rogachevo
Building a house in Balchik, Rogachevo
All the construction works are on schedule. The skilled workers of building company "Varaks" fit the underfloor heating system and did the screeding in the entire house.
The outdoor building works also continue. We fit the roof timber structure and then fit the waterproof insulation too. After that our workers fit the double grid wooden battens and carried out the roof tiles on the roof, ready to be fitted.
Building a house in Balchik, Rogachevo
Busy works on the building site. The construction works done of this house in Balchik, Rogachevo, at this stage are - perfectly fit water and sewarage system in the house, impeccable works of the coating and plaster in the rooms, preparation works of making the roof.
Building company "Varaks" made the concrete ring on the roof concrete plate and prepares the timber material for the roof.
Building a house in Balchik, Rogachevo
All the construction works at this house near Balchik continue. In June, building company "Varaks" managed to do and fit the el.installation of the entire house as well as the concrete base of the roof structure.
The landscaping, plastering and many other works are about to be done in July.
Building a house in Balchik, Rogachevo
The building works of this house in Balchik continue. Our bricklayers build up the brick base of the roof. Construction company "Varaks" keeps on installing the water/sewage system and the el.systems in the house too.
Building a house in Balchik, Rogachevo.
Building company Varaks is proud of the hand made big furnace which was built with the highest level of workmanship. Our professional workers did a great job.
The building works of this project in Balchik continue with the water and el. instalastion of the main house.
Building a house in Balchik, Rogachevo.
Building company Varaks continue the masonry works in the house. In February our workers also built a septic tank for the guest house. A special feature of the project is a hand made big furnace.
Building a house in Balchik, Rogachevo.
Construction company "Varaks" workers fitted high class UPVC windows, the double glazing is 45 mm and all the materials are of high quality.
The outdoor furnace is almost ready.

The building works of this house in Balchik, Rogachevo, are on schedule. All the construction works have been done depending on the weather conditions.
Construction company "Varaks" completed the brick masonry of the house and have began the building works of a big outdoor furnace which is located next to the guest house.
The building works of the house in Balchik continue.
In October the builders of construction company "Varaks" removed the shuttering of the first floor concrete plate and started the masonry of the ground floor walls.
The guests house and BBQ area have been built and ready to use.
The weather in September was very good and allow us, the builders, to work on schedule. The building works of the house in Balchik continue fast. Our specialists make the shuttering of the first floor, put thermal insulation into the concrete plate, fit the reinforcement bars and poured concrete.
The construction of this house in Balchik, Rogachevo is on schedule.
The summer kitchen/BBQ area is almost finished - floor tiles, wooden cladding on walls and ceiling, newly fitted kitchen. All the indoor area was thouroughly cleaned with a vacuum cleaner for building purposes .
The building works of the house in Balchik go on. The shuttering for all the ground floor columns is done and our concrete mixer supplied and poured concrete into the columns.
The foremen of building company "Varaks" have started the levelling works and preparation for the first floor concrete plate shuttering and reinforcement works.
The owner of the house who is a sailor , is back to Bulgaria, and the construction works of this house in Balchik, Rogachevo village continue.
The BBQ area,summer kitchen and veranda were built
The tilers keep on fitting decorative bricks on the walls of the summer kitchen as well floor and walls tiling. The shower room of the summer kitchen is ready to use too.
The workers of building company "Varaks" make the brick masonry of the first floor of the main house.

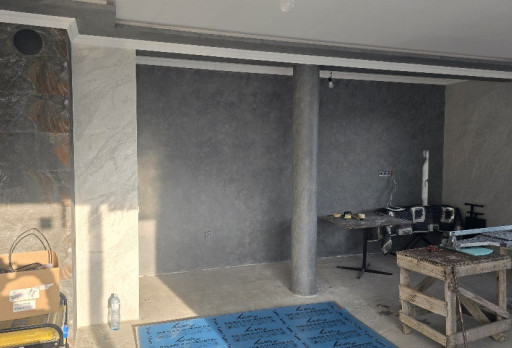

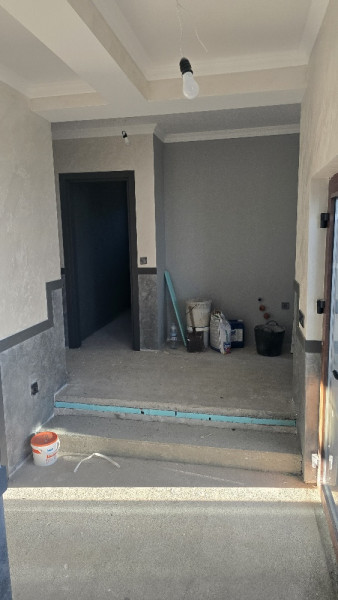

The building works in village of Rogachevo continue with the laying of two-component waterproofing on the concrete slab. The bricks have been delivered and the preparation for masonry begins. An excavation for a septic tank is dug. Then the masonry with stones of the walls of the septic tank begins.
PVC windows are installed on the barbecue and on the basements. Drainage has been made around the house. The metal panels of the fence are installed. The wooden parts of the barbecue are varnished.
The shuttering of the perimeter wall is removed and the walls of the house are being waterproofed . The construction of the walls of the barbecue continues. Waterproofing has been done in the foundations of the house as well as thermal insulation also in the foundations of the house. The fence to the south side of the property is ready. The masonry of the barbecue is done.
The concrete is poured and vibrated. The wall of the barbecue is masoned with YTONG. Steel metal is fitted for the fascia. The shuttering is removed from the walls. An excavation was made for a septic tank. The shuttering is done and reinforcement is fitted to the slab at elevation 0 of the basements. The masonry of the drainage shaft is being done. Excavation works for perimeter wall and concrete pouring are in progress.
Thermal insulation is installed on the slab elevation 0. The reinforcement is fitted and pouring of the concrete begins. The reinforcement is laid on the walls at elevation -2,8 and then the formwork is fitted before pouring the concrete. The concrete is poured.
The concrete for level -2,8 has been poured. The wooden structure of the arbour has been completed. Bituminous primer and bituminous tiles have been laid on its roof. Gutters and downpipes are installed. The shuttering of the living room slab is fitted. Bituminous primer was laid on the basement walls at level -2.8 m. The reinforcement at level -2.8 m for the walls of the rear basements is fitted.
Preparations for pouring and pouring of concrete for the base are underway. Next step is grinding the poured concrete. Reinforcement is fitted for the walls of the basement of the house. Shuttering is fitted for the walls of the house.
Preparation for underlying concrete for the house is in progress. The construction of the arbour is ready.
The reinforcement for the foundations has been prepared and fitted. Concrete is poured in the foundations. The reinforcement of the columns is also fitted.
The excavations for foundations begin. The earth is loaded and removed. The trench is shaped by hand. The building is outlined. Initial concrete base is poured.
The works begin with setting out the ground tracing before the excavation works. A construction trailer is delivered. Then the shuttering is fitted. We install the reinforcement in order to prepare for pouring concrete for a storage patio on the site. The concrete is then poured and grinded.
